The decision to implement GRC software is the easy part. The harder part — and the part where most projects either succeed or quietly fail — is the implementation itself. Across organisations of all sizes, the same challenges appear repeatedly: data migration problems, low adoption rates, scope creep, and the risk register that’s populated in month one and ignored by month six.
For a comprehensive guide to selecting the right platform before you begin, see our GRC software buyer’s guide for Australian organisations.
This article examines the most common challenges organisations face when adopting GRC software, and provides practical guidance on overcoming each one. Whether you’re planning your first GRC implementation or rescuing a stalled deployment, understanding these patterns is the first step to avoiding them.

Challenge 1: Migrating Data from Spreadsheets
For most organisations, the starting point for GRC software is a collection of spreadsheets — risk registers, compliance checklists, incident logs, audit findings. These spreadsheets have typically grown organically over years, with inconsistent terminology, duplicate entries, outdated content, and no standardised structure.
The temptation is to migrate everything into the new platform as-is. Resist it. Data migration is an opportunity — perhaps the best you’ll ever have — to clean, standardise, and rationalise your GRC data. Migrating poor-quality data produces a poor-quality GRC system that replicates existing problems in a more expensive tool.
The recommended approach is to treat migration as a data quality exercise first. Before moving anything into the platform, audit your existing risk register: remove duplicate risks, standardise risk descriptions to a common format (“Likelihood × Consequence” or “Cause-Event-Consequence”), assign definitive owners, and discard risks that are no longer relevant. Then migrate the clean dataset. This typically takes longer upfront but produces dramatically better outcomes.

Challenge 2: Securing Stakeholder Buy-In
GRC software only works if the people responsible for risks and compliance obligations actually use it. This seems obvious, but the stakeholder adoption challenge is consistently cited as the most significant barrier to successful GRC implementation.
The root cause is usually framing. When GRC software is presented to operational managers as “a new compliance tool” that creates additional administrative work, resistance is predictable. When it’s framed as a tool that protects the manager from being blindsided by risks in their area, reduces the time they spend on compliance-related admin, and gives them visibility they didn’t previously have, the reception is very different.
Executive sponsorship is non-negotiable. When the CEO or executive team visibly uses GRC software — references it in management meetings, asks for risk dashboard updates, expects compliance status reports to come from the platform — the signal to the rest of the organisation is clear. GRC tools adopted without executive sponsorship rarely achieve the usage levels needed to justify their cost.
For a detailed walkthrough of managing the implementation process, including stakeholder engagement strategies, see our comprehensive guide to implementing GRC software step-by-step.
Challenge 3: Defining Risk Taxonomy and Categories
The question “how do we categorise our risks?” sounds straightforward until you’re in a room with your risk owners trying to answer it. Does cyber risk sit under operational risk or technology risk? Is a WHS incident an operational risk or a compliance risk? Where does reputational risk live? These debates can consume weeks of implementation time if not structured carefully.
The most effective approach for most organisations is to start with an established risk taxonomy — ISO 31000, the IRM’s risk categories, or the platform vendor’s recommended starting framework — and adapt it to your context. You do not need to invent a risk taxonomy from scratch, and the marginal benefit of a bespoke taxonomy rarely justifies the time investment.
Accept that your taxonomy will evolve. The most important thing is to get started with a workable structure and refine it as experience accumulates. A risk register with an imperfect taxonomy that’s actively maintained is vastly more valuable than a perfect taxonomy that’s still being debated a year after implementation began.
Challenge 4: Integrating with Existing Business Systems
Organisations rarely start from scratch on GRC. There’s typically an existing incident reporting system, a policy management tool, a document management platform, and possibly HR and financial systems that contain risk-relevant data. The question of how — and whether — to integrate these with the new GRC platform is a significant implementation decision.
The practical advice is to resist the urge to integrate everything in phase one. Deep system integrations are technically complex, time-consuming, and expensive to maintain. Start with the standalone GRC platform and manual data flows where necessary; identify the one or two integrations that would deliver the most operational value; and implement those as a phase two or three investment.
The integration that typically delivers the most value earliest is between the GRC platform and the organisation’s email system for workflow notifications — ensuring that risk owners receive automated reminders for upcoming reviews and overdue actions without requiring anyone to manually chase them. This integration is typically straightforward and immediately reduces the administrative burden on GRC administrators.
Challenge 5: Keeping Risk Data Current After Go-Live
The most frequently encountered post-implementation failure mode is the risk register that was accurate on day one and drifted into irrelevance over the following six months. Risk owners stop updating their entries, new risks aren’t added, closed risks stay in the register, and the system gradually stops reflecting organisational reality.
This is fundamentally a governance and process problem, not a technology problem. The platform can send reminders, but it can’t force engagement. The solution lies in embedding GRC platform reviews into existing management rhythms — making risk register review a standing agenda item in team meetings, tying compliance obligation attestations to existing calendar events (end of quarter, annual regulatory submissions), and ensuring management visibility makes non-compliance with review obligations visible.
Assigning a named GRC platform administrator — not just a risk owner, but someone with oversight responsibility for the health of the entire system — is critical. This person doesn’t need to own every risk or compliance obligation, but they need to be responsible for ensuring that the platform’s data is current, that reviews are being completed, and that the system continues to reflect organisational reality.

Challenge 6: Managing Implementation Scope
Scope creep is endemic to GRC implementations. What starts as “let’s get the risk register live” quickly expands to “we should also do the compliance register, incident management, policy library, and audit module — while we’re at it.” Each addition seems reasonable in isolation; collectively they push the go-live date out indefinitely and increase the risk of the project being deprioritised entirely.
The antidote to scope creep is a clearly defined phase one with an explicit exclusion list. Document what is in scope for phase one and — critically — what is explicitly out of scope and will be addressed in phase two. This has two benefits: it focuses the implementation team, and it provides a response to stakeholders who want to expand the scope (“great idea — we’ve logged that for phase two”).
For a detailed framework for phased GRC implementation, including scope planning and phase gate criteria, see our step-by-step guide to implementing GRC software in Australian organisations.

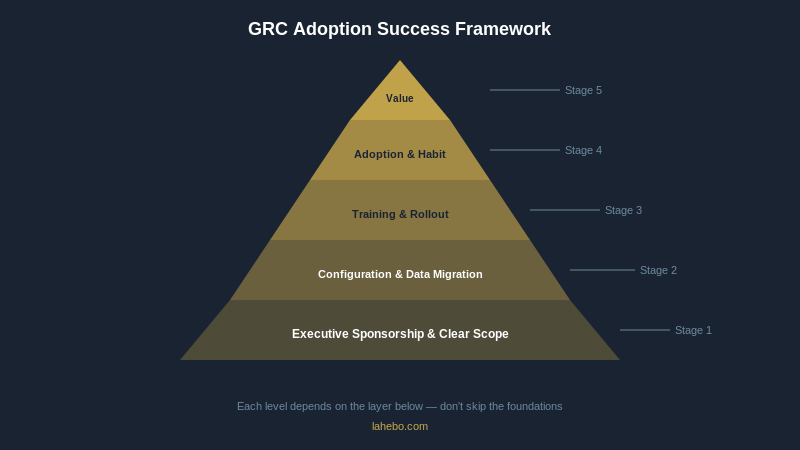

Building for Success: The GRC Adoption Framework
Successful GRC adoption follows a predictable pattern. The organisations that get it right share five characteristics: clear executive sponsorship from day one; a defined and bounded phase one scope; clean data migration rather than legacy data transplant; training and rollout that’s embedded in existing workflows rather than bolt-on; and a named platform owner who maintains ongoing system health.
The organisations that struggle share a different pattern: implementation driven by the IT team rather than risk and compliance leadership; an attempt to implement everything simultaneously; migration of uncleaned spreadsheet data; a launch event followed by no ongoing governance; and expectations that the platform will self-manage.
The good news is that these patterns are well understood, and the corrective actions are known. Even organisations that have experienced a stalled GRC implementation can recover — by scoping a restart, cleaning data, securing executive re-engagement, and rebuilding adoption methodically.
The ROI Case for Getting Implementation Right
The cost of a failed GRC implementation isn’t just the licence fees — it’s the opportunity cost of organisational risk exposure that structured GRC would have mitigated, the management time invested in the implementation, and the reputational and credibility damage of a visible technology project that didn’t deliver. For a detailed analysis of the financial case for GRC investment, see our comprehensive guide to the ROI of GRC software and how to build a business case.
Conversely, a well-implemented GRC platform compounds in value over time. As risk data accumulates, patterns become visible. As compliance monitoring matures, the cost of audit preparation falls dramatically. As incident data builds, root cause analysis becomes more rigorous. The platform pays for itself more convincingly each year — provided it was implemented well enough to actually be used.
Conclusion
GRC software adoption challenges are well-documented and largely predictable. Data migration complexity, stakeholder buy-in, taxonomy debates, integration scope, data currency, and scope creep appear in virtually every implementation — but none of them are insurmountable. The organisations that succeed understand that GRC software adoption is fundamentally a change management project, and invest in the process dimensions as seriously as the technical ones.
Lahebo is designed to lower the barriers to adoption at every stage — with templates that reduce taxonomy debates, clean onboarding processes that simplify data migration, automated workflows that keep data current, and an intuitive interface that drives voluntary engagement from risk owners. The technology is built to support successful adoption, not just successful installation.
