Implementing GRC Software: A Step-by-Step Guide for Australian OrganisationsReading Time: 7 minutes

Implementing GRC software is one of the highest-value IT projects a risk or compliance team can initiate. Done well, it transforms a manual, fragmented programme into a systematic, visible, and audit-ready function. Done poorly, it produces an expensive system that nobody uses and a risk programme that’s no better than before.

The difference is usually not the software — it’s the implementation approach. This guide provides a practical, step-by-step framework for implementing GRC software in an Australian organisation, from initial planning through to post-go-live measurement. For organisations still in the evaluation phase, see our guide to GRC software for Australian businesses. If you’re weighing the financial case for the investment, our article on the ROI of GRC software covers the business case framework.

Step 1: Planning and Scoping

Before you configure a single setting in your new GRC platform, you need a clear picture of what you’re implementing, for whom, and what success looks like. The planning phase is frequently rushed because there’s excitement about getting the new platform running — but shortcutting it almost always leads to scope creep, stakeholder misalignment, or a platform that doesn’t actually meet the organisation’s needs.

Define the scope explicitly: Which business units are included in the initial implementation? Which risk categories will be managed in the platform from day one? Which compliance obligations will be migrated immediately versus added in a second phase? Is incident management in scope initially or a Phase 2 addition? Clear scope documentation prevents the “can we just add this?” requests that expand timelines and add complexity.

Identify your stakeholders and get executive sponsorship confirmed in writing. A GRC implementation that doesn’t have active executive support typically fails at the adoption stage — risk owners revert to spreadsheets, compliance managers maintain parallel records “just in case,” and the platform becomes a reporting-only tool rather than the source of truth. Executive sponsorship is the single most important factor in successful adoption.

Define success metrics upfront: What does a successful implementation look like at 30, 60, and 90 days? Typical metrics include percentage of risks migrated, percentage of compliance obligations mapped, time spent on monthly risk reporting (before vs. after), and user adoption rate. Having agreed metrics makes it possible to assess implementation success objectively rather than relying on subjective impressions.

Step 2: Data Audit and Preparation

The data audit is the most underestimated step in GRC implementation. Most organisations have years of risk and compliance data scattered across spreadsheets, shared drives, email threads, and the institutional knowledge of key individuals. Before this data can be migrated to a new platform, it needs to be reviewed, standardised, and in many cases updated.

Audit your current risk register: how many risks are in it, how current is the data, are risk ratings and descriptions consistent, and who is responsible for each risk? Audit your compliance obligations: is there a comprehensive list, is it current, and who owns each one? Identify gaps where risks exist in practice but aren’t documented, or where compliance obligations are managed informally but not recorded anywhere.

This process often reveals that the existing risk and compliance data is less complete and current than it appeared. That discovery is valuable — it’s better to understand the state of your data before migration than to discover it afterwards. Treat the data audit as an opportunity to clean up and improve your risk programme, not just to transpose existing data into a new system.

Step 3: Platform Configuration

Configuration involves setting up the platform to reflect your organisation’s structure, risk framework, and compliance requirements. For cloud-based platforms like Lahebo, this is typically done through an administrative interface rather than requiring technical development — but it still requires thoughtful decisions about how the platform should work.

Key configuration decisions include: risk scoring matrices (likelihood scales, consequence scales, combined risk score calculations, risk appetite thresholds), risk categories and taxonomy, user roles and access permissions, review cadences for risks and compliance obligations, notification rules and escalation triggers, and reporting dashboard layouts. For each of these decisions, refer back to your existing risk methodology — the platform should reflect how your organisation already thinks about risk, not force a new framework.

Good vendors provide configuration templates and onboarding support that significantly reduce the time required for this step. Lahebo includes pre-built templates for Australian WHS, privacy, and governance obligations, and provides implementation support to help organisations configure the platform correctly rather than starting from a blank slate.

Step 4: User Training and Testing

User training is where many GRC implementations underinvest. The instinct is to provide a demonstration of the platform, send users a link to the documentation, and consider training done. This approach consistently produces poor adoption because it treats the platform as self-explanatory rather than acknowledging that changing how people manage risk is a change management challenge, not a technology installation.

Effective GRC training is role-specific: risk owners need different training from compliance managers, who need different training from executives who will be viewing dashboards. Each group should understand what they’re expected to do in the platform, why it matters, and how to do it. Practical exercises — actually updating a risk, completing an obligation attestation, generating a report — are more effective than passive demonstrations.

User acceptance testing (UAT) before go-live is essential. Have a representative sample of users from each role group run through their typical workflows in the platform and report any issues. UAT catches configuration problems that weren’t apparent during setup — a notification rule that triggers too frequently, a risk scoring matrix that doesn’t map correctly to the organisation’s methodology, a report format that doesn’t meet the board’s needs.

Step 5: Go-Live Preparation and Launch

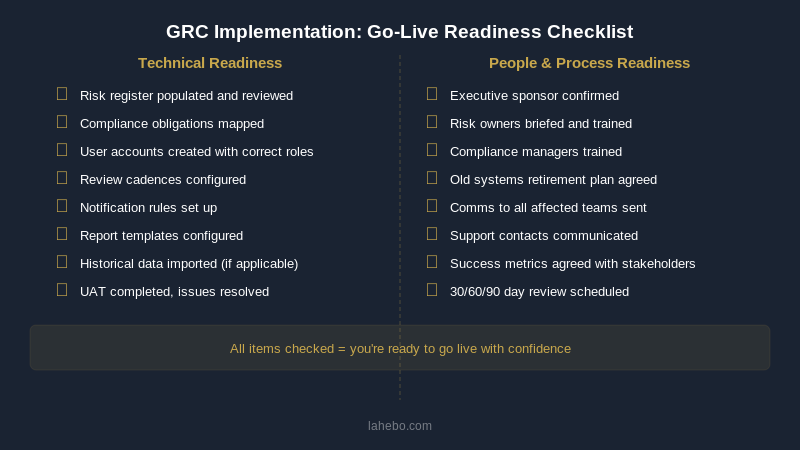

GRC software go-live readiness checklist: technical and people readiness

Go-live is a milestone, not a finish line. The preparation for go-live involves completing the technical and people readiness checklist and communicating clearly with all affected stakeholders about what is changing and when. The most important communication is to risk owners: they need to know that from go-live date, they should be updating their risks in the new platform rather than in spreadsheets, and what happens to the old spreadsheets (they should be archived, not deleted immediately, but they should no longer be updated).

A phased go-live reduces risk for larger implementations. Rather than switching all users and all functions on simultaneously, a phased approach — starting with the risk register for a pilot business unit, then expanding to all units, then adding compliance obligations, then incidents — allows problems to be identified and resolved at smaller scale before full rollout.

Step 6: Measuring Success and Continuous Improvement

The 30-60-90 day review cycle is the mechanism for measuring implementation success and identifying areas for improvement. At 30 days, focus on adoption: are users logging in, updating their risks, completing obligation tasks? At 60 days, focus on data quality: is the risk register current, are compliance statuses accurate, are report outputs meeting stakeholder expectations? At 90 days, focus on programme value: has reporting time decreased, are risks being actively managed rather than just recorded, is audit preparation becoming easier?

Common issues that emerge in the first 90 days include low adoption from specific teams or roles, configuration decisions that need adjustment based on real usage, and training gaps where users understand the mechanics of the platform but not the risk management concepts it’s designed to support. These are all addressable — but they need to be identified and tracked, which is why the review cycle and success metrics established in Step 1 are so important.

Common Implementation Pitfalls to Avoid

The most common causes of GRC implementation failure are: insufficient executive sponsorship (risk owners don’t see the platform as a priority), over-ambitious initial scope (trying to implement everything at once rather than a phased approach), poor data quality in the source systems (migrating outdated or incomplete risk data creates a poor foundation), inadequate user training (treating technology deployment as the end goal rather than behaviour change), and choosing the wrong platform for your organisation’s size and complexity.

For more detail on the specific challenges organisations face when adopting GRC software and how to overcome them, our article on overcoming GRC software adoption challenges covers each of these in depth.

Frequently Asked Questions

How long does GRC software implementation typically take?

Implementation timelines vary significantly by platform type and organisational complexity. Enterprise GRC platforms (RSA Archer, ServiceNow GRC) typically require six to eighteen months. Mid-market platforms require two to six months. Cloud-based platforms designed for mid-market and SME organisations — like Lahebo — are typically operational within two to four weeks for the initial configuration, with full programme migration completed over the following four to six weeks. The key variable is the time required to audit and prepare existing data, which can extend timelines if existing risk and compliance records are incomplete or inconsistent.

How much IT resource does GRC implementation require?

For cloud-based platforms, IT involvement is typically minimal. There is no server infrastructure to provision, no software to install, and no database to manage. IT involvement is usually limited to SSO or identity management configuration, network security review, and possibly an API integration with other systems. The majority of implementation work is done by the risk and compliance team, not IT — which is both more efficient and produces better outcomes, since the people configuring the platform understand the risk and compliance requirements it needs to support.

What’s the most important change management consideration in GRC implementation?

Consistently, the most important factor is getting risk owners to understand “what’s in it for me.” Risk owners — the managers responsible for updating and maintaining risks in their area — bear much of the ongoing effort of a GRC programme. If they see the platform as another administrative burden rather than a tool that helps them, adoption will be poor. The most effective approach is to demonstrate directly to risk owners how the platform reduces their workload: automated review reminders instead of manual follow-up, one-click reporting instead of manual assembly, clear visibility of what’s overdue rather than having to track it manually.

Implementation Is the Beginning, Not the End

A successful GRC implementation is the foundation of a mature, effective risk and compliance programme — not the programme itself. The platform provides the infrastructure; the risk and compliance culture, the quality of risk data, and the engagement of risk owners is what determines whether that infrastructure is used well.

Take the implementation seriously, invest in data quality and user training, get executive sponsorship, and measure success at 30, 60, and 90 days. The organisations that do this consistently report that GRC software delivers on its ROI promise. Those that rush implementation and skip the hard parts typically find themselves with an expensive tool that doesn’t get used.

Ready to implement GRC software with expert support? Book a consultation with the Lahebo team — we provide hands-on implementation support to help Australian organisations get operational quickly and effectively.
